Tessera Free Quote

Concrete

Concrete
in Kansas City.

Driveway concrete, patio concrete, walkways, and pads — air-entrained mix, properly compacted sub-base, code-spec control joints. The KC concrete contractor who builds slabs to survive Kansas City freeze-thaw, not just to look good on day one. Detailed quote within 24 hours.

What we handle on a concrete pour

Most concrete failures in Kansas City are caused before the truck arrives. A poorly compacted sub-base, the wrong mix, or improper control-joint spacing produces a slab that looks fine for one summer and then cracks, spalls, or heaves through the first two or three winters. The crew that spends the extra hours on prep, mix-spec, and finish details is the crew whose work is still flat 15 years later. Those hours are the work.

Our scope on a typical concrete project includes:

  • Demo & tear-out — existing slab break-out, debris hauled to recycle (most KC concrete is recycled into aggregate base for new pours). Disposal fee included in the line item, not added later.
  • Sub-grade prep — topsoil and unstable material excavated, clay sub-grade evaluated, drainage routed away from the slab area. Where existing sub-grade is unstable (loose fill, organic, undermined), we bring in stable fill and compact in lifts.
  • Aggregate base — 4-6" of compacted 3/4" minus aggregate or recycled concrete base, placed in lifts, compacted with a plate compactor or roller (not just dumped and stepped on). Proper grade established for drainage pitch.
  • Forms — 2x4 or 2x6 forms set to finish grade, staked and braced for the pour, internal forms for stairs / steps where required. Edges chamfered or rounded per finish spec.
  • Reinforcement — fiber mesh (default for driveways, patios, walkways) or #4 rebar grid (for heavier-load slabs, structural pours, or per engineering drawings). Tied wire chairs for rebar, not pulled up after pour.
  • Mix spec — 4,000 psi, air-entrained (5-7% air content for KC freeze-thaw), 4" slump, water-cement ratio per spec. We verify the mix on the truck ticket before pour starts. We do not field-add water to make placement easier — that dilutes strength and shortens slab life.
  • Pour & placement — concrete placed via chute or pump as access dictates, screeded to grade, bull-floated, edged, and given the appropriate finish (broom, smooth, stamped, exposed aggregate, salt finish, etc.).
  • Control joints — saw-cut within 12-24 hours of pour to a depth of 1/4 of slab thickness, spaced roughly 2.5x slab thickness in feet (10-foot grid for a 4" slab). Skipped or wrong-spaced joints are the #1 cause of random cracking. We do not skip them.
  • Curing — cure compound applied or wet-cure / blanket-cure depending on weather. Proper cure produces stronger, more durable concrete — especially in hot or windy KC weather where surface water evaporates before the cement can hydrate.
  • Stripping & sealing — forms removed at appropriate cure point, edges cleaned, optional concrete sealer applied (we recommend a penetrating siloxane sealer at year 1 and every 3-5 years thereafter).
  • Cleanup & final walk — debris hauled, site cleaned, control joints inspected, customer walk-through with you to mark any issues for warranty.

What to expect — timeline and draws

Most KC concrete projects run 2 to 5 working days of on-site work, plus a 7-day light-traffic cure window and a 28-day full-strength window. Tear-out and prep is one of those days; forming and reinforcement is the next; pour and finish is the next. Larger driveways, multi-section pours, or stamped / decorative work add 1 to 3 days.

Before any concrete is ordered, you receive a written schedule with the forming day, the pour day (this is weather-dependent — we do not pour at temperatures below 40°F or with rain forecast within 12 hours of finishing), and the safe-to-drive date for your conditions. Draws against the contract are tied to milestones rather than the calendar:

  • 30% at signing — secures the schedule slot, locks the concrete batch order.
  • 60% at substantial completion — slab poured, finished, joints cut, forms stripped, cure applied.
  • 10% retained until 7-day cure complete and any surface issues addressed.

Pricing factors

Kansas City residential concrete generally falls into these bands:

  • Driveway replacement — 600-900 sq ft, 4" thickness, broom finish, fiber mesh: $5,000 to $11,000.
  • Driveway with rebar — same scope with #4 grid reinforcement: $5,800 to $12,500.
  • Patio — 200-400 sq ft, 4" thickness, broom finish: $1,800 to $5,500. Larger patios scale roughly linearly.
  • Walkway — 4-foot-wide standard, broom finish: $20 to $40 per linear foot.
  • RV / heavy pad — 6" thickness, rebar grid, additional sub-base depth: $2,000 to $6,000+ for a typical 12x30 pad.
  • Stamped / colored — add $4 to $10 per sq ft over base price for stamping, color, sealing.
  • Exposed aggregate — add $3 to $7 per sq ft over base price.
  • Tear-out of existing — $1,500 to $4,000 depending on slab thickness, reinforcement type, and access.

Where your project lands depends on:

  • Site access — can the concrete truck reach the pour location? Backyard patios that need a pump truck or wheelbarrow chain add cost.
  • Sub-grade condition — stable, well-drained sub-grade is cheap. Soft clay, undermined, or organic sub-grade requires additional excavation and stable fill.
  • Drainage — if water management around the slab requires drains, swales, or grade changes, those are quoted separately.
  • Decorative finish — broom is cheapest. Smooth-trowel is mid. Stamped, exposed aggregate, salt finish, or colored adds proportionally.
  • Reinforcement choice — fiber mesh: included in mix at minimal cost. Rebar grid: $800-$1,500 premium on a residential driveway.

Why customers pick Tessera for concrete

  • You hear back fast. Quote within 24 hours, not three weeks.
  • Sub-base is compacted in lifts, not dumped-and-stepped-on.
  • Air-entrained mix every exterior pour. We verify on the truck ticket.
  • Control joints saw-cut on-time, on-spec spacing. No random cracks because we skipped a joint.
  • No field-added water at the chute — mix strength is what was ordered.
  • The schedule includes the safe-to-drive date for your specific pour conditions, not a generic guess.
  • You retain 10% until 7-day cure complete and surface punch-list addressed.

Past work

A few projects we have led.

  • Finished concrete patio with deck stairs descending to it at golden hour
    Photo: concrete patio pour led by our team — completed for Hearthside Homes

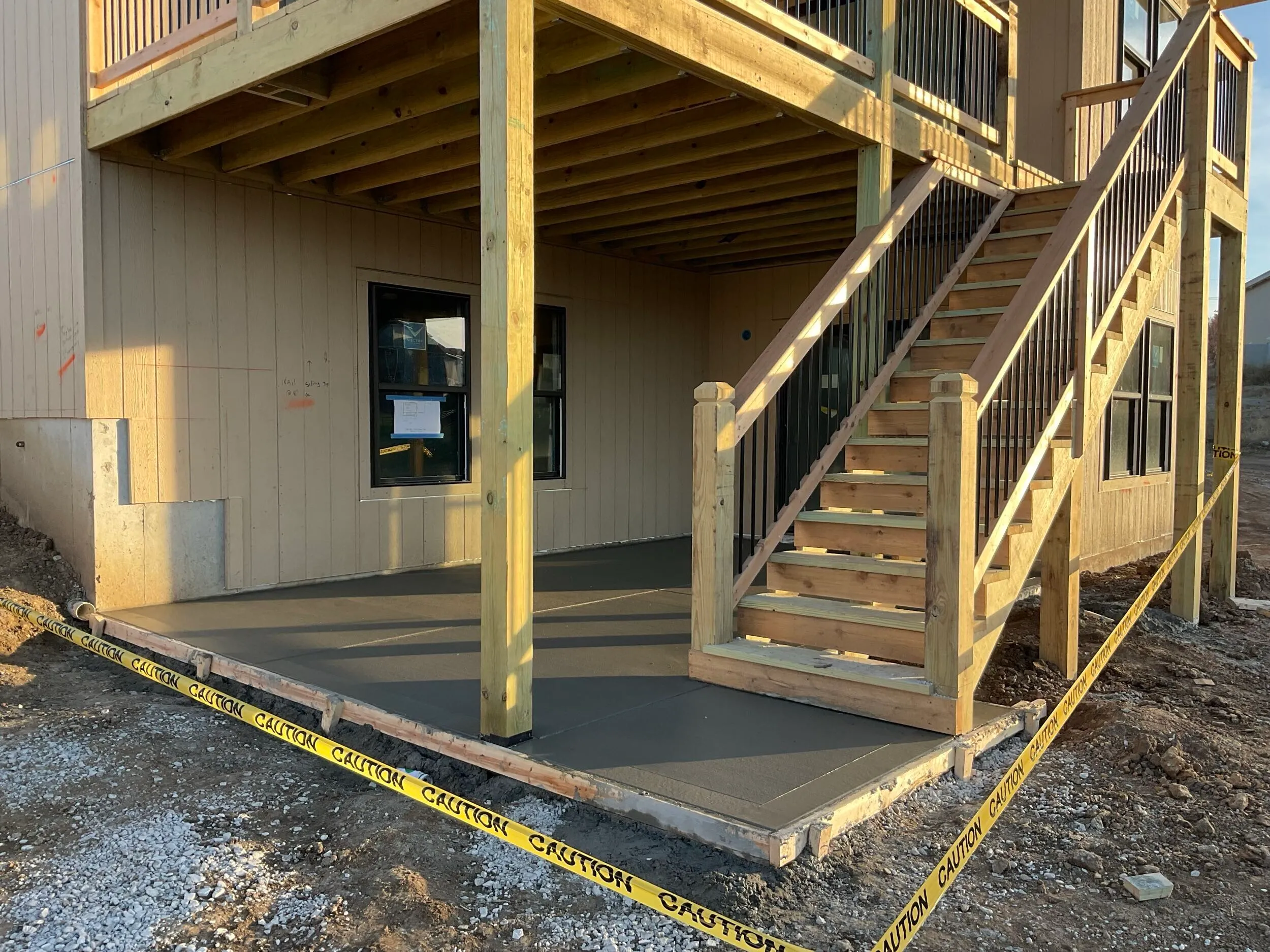

  • Concrete patio poured under a covered deck with a fresh broom finish
    Photo: concrete patio pour led by our team — completed for Hearthside Homes

  • Curved concrete walkway and step pad next to a new build
    Photo: concrete walkway pour led by our team — completed for Hearthside Homes

Concrete FAQ

What homeowners ask us most.

How long does a concrete job take in Kansas City?

A standard driveway pour (600-900 sq ft) takes 2 to 4 working days: one day for tear-out and sub-base prep, one day for forming and reinforcement, one day for the pour and finishing, plus a curing window before vehicle traffic (typically 7 days for cars, 28 days for full design strength). Patios run similar. Larger or multi-section pours and stamped/colored work add 1 to 3 days.

When can I drive on a new concrete driveway?

Foot traffic: 24-48 hours after pour. Light vehicles (passenger cars): 7 days minimum. Full design strength (heavy vehicles, full loads): 28 days. KC weather affects cure: cool, damp weather extends the wait; hot, dry weather actually slows surface strength gain even though it feels harder faster (water evaporates before it can hydrate the cement). We tell you the actual safe-to-drive date for your specific pour conditions, not a generic "give it a few days."

What does a concrete driveway cost in KC?

For a standard 600-900 sq ft replacement driveway with a 4" thickness, broom finish, code-compliant sub-base, control joints, and fiber-mesh reinforcement, plan on $5,000 to $11,000. The same driveway with #4 rebar reinforcement instead of fiber mesh adds $800-$1,500. Stamped or colored concrete adds $4-$10 per sq ft on top of base ($2,400-$9,000 premium on a 600-sq-ft driveway). Tear-out of an existing driveway adds $1,500 to $4,000 depending on thickness and access.

Why does concrete crack? Will mine?

All concrete cracks. The question is whether it cracks in the joints we put there on purpose, or in random places we didn't. Concrete shrinks as it cures and continues moving with KC's freeze-thaw cycles for years. Properly placed control joints (saw-cut within 12-24 hours of pour, depth 1/4 of slab thickness, spacing roughly 2.5x slab thickness in feet — so 10-foot grid on a 4" slab) give cracks somewhere structured to go. Skipped or improperly spaced joints produce random cracks, usually within the first 2 winters. We do not skip joints. We do not space them at the wrong distance.

Sub-base — why does it matter?

Concrete is rigid; it does not flex. If the sub-base shifts, settles, or freeze-heaves, the slab cracks. KC sub-base discipline: 4-6 inches of compacted aggregate (3/4" minus or recycled concrete base) over a stable, drained sub-grade. Compaction in lifts (not all dumped and rolled once). Proper grade pitch for drainage (driveways slope to the street; patios slope away from the house at 1/8" per foot minimum). Sub-base done wrong is the #2 cause of concrete failure in KC after improper joints. We dig and prep correctly.

Fiber mesh vs rebar — what do you use?

Fiber mesh (synthetic or steel fibers mixed into the concrete itself) is our default for residential driveways and patios — it controls plastic-shrinkage cracking during cure and does not rust. Rebar (#4 grid) gets used on slabs that carry heavier loads (RV pads, garage floors with heavy use, slabs over questionable sub-base) or where structural-engineering drawings call for it. Rebar handles structural cracking after cure; fiber handles shrinkage during cure. Some pours use both. We pick the right one for your job and explain why.

What about air-entrained mix for KC freeze-thaw?

Yes, every exterior concrete pour in KC should use air-entrained concrete (typically 5-7% air content for 4,000 psi residential mix). The microscopic air bubbles give freezing water somewhere to expand without spalling the surface. Non-air-entrained exterior concrete fails within 5-10 winters in our climate. We spec the right mix at the batch plant and verify on the truck ticket; we do not "field-add" water at the site, which dilutes the mix and reduces strength.

How are payments structured?

Standard schedule on a concrete project is 30% at signing (locks materials and schedule slot), 60% at substantial completion (slab poured, finished, joints cut, control measures in place), and 10% retained until the punch list is fully signed off and the slab has had 7 days of cure (any cosmetic surface issues that show up in the first week are addressed before final payment).

Next step

Ready to pour?

Send the project details and we will be back within 24 hours with a real, detailed estimate — including sub-base and reinforcement specs, not a placeholder range.
